We started construction of Aspen Power Station in April 2024. We’re planning for it to be fully built and operating in 2027.
Please view this album for more construction photos.
View the construction timelapse video.
Our Construction Progress So Far
|
73% Construction complete |
77% Overall project complete |
2.5 million Hours worked on site so far |
|
>2,800 Workers oriented since start of construction |
252 Local Saskatchewan companies involved |
>581 million Awarded to local companies |
*Progress stats as of June 1, 2026

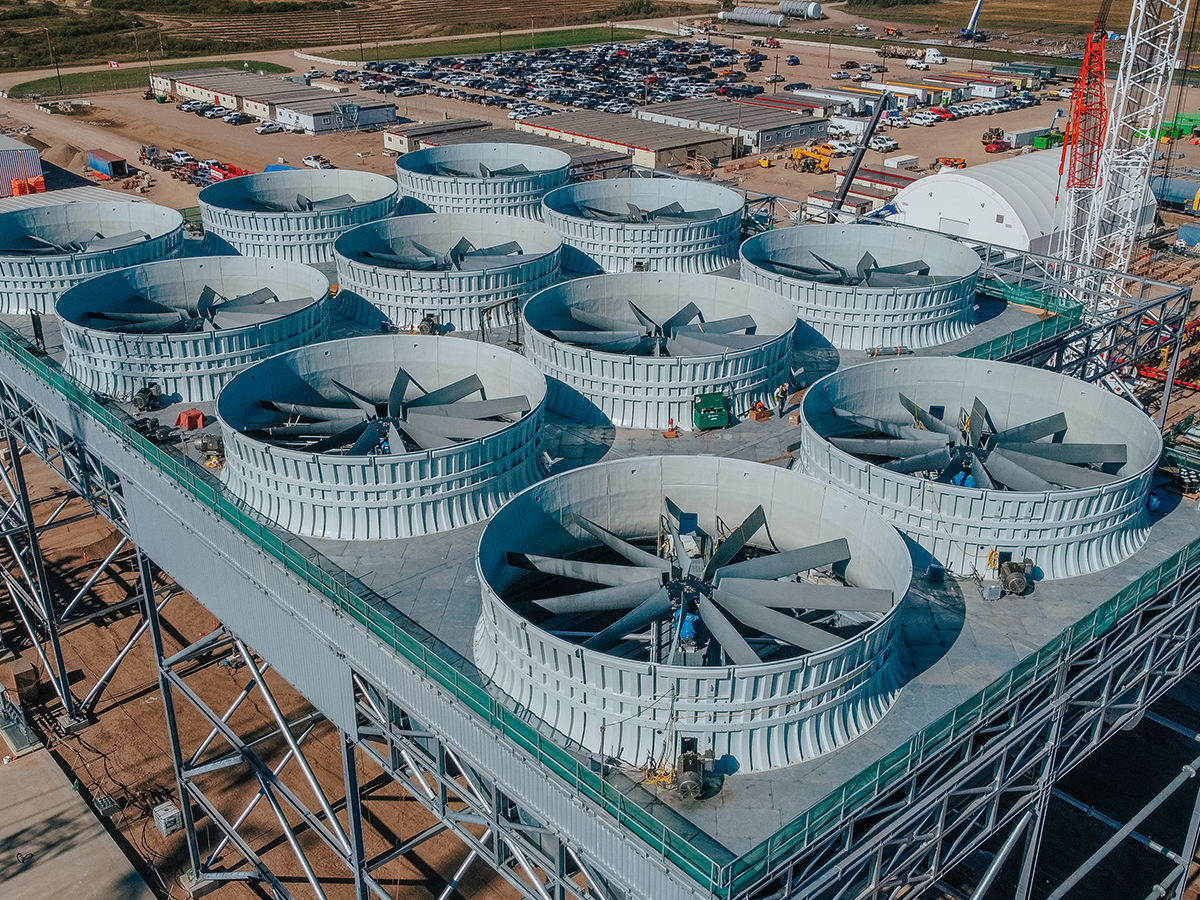

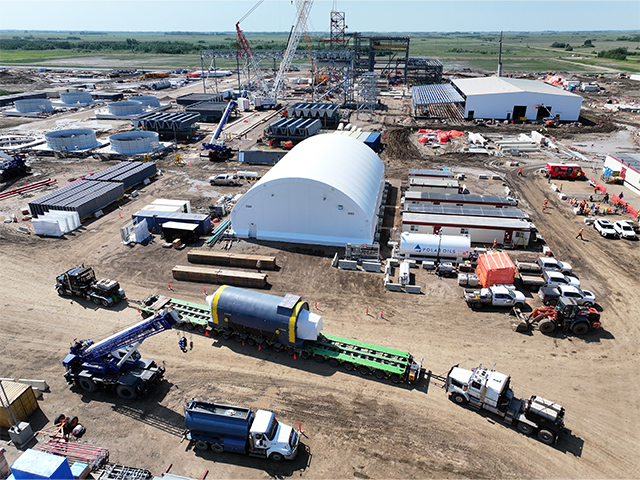

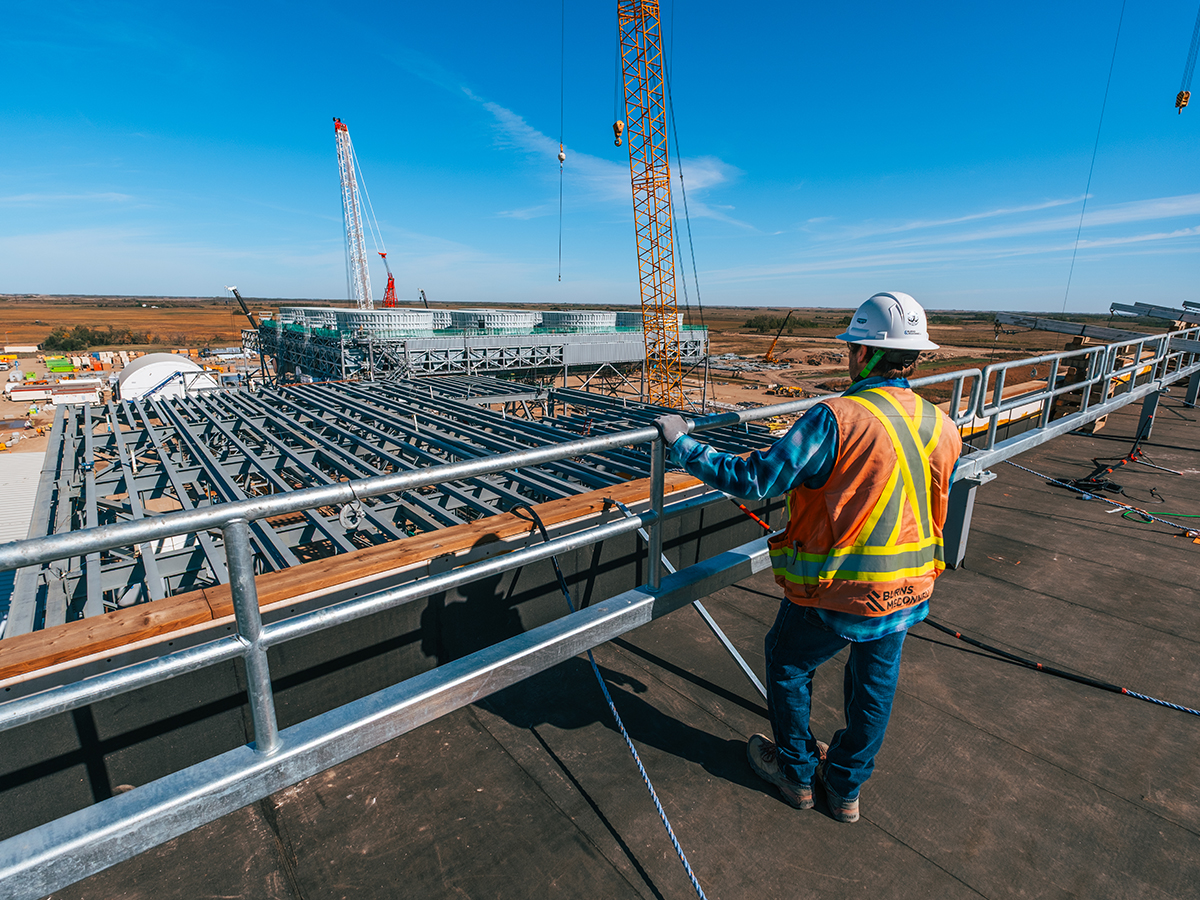

- Spring 2026 – We’re now entering the peak construction phase for Aspen. This means up to 800 workers will be on site on any given day from May through the summer months. Mechanical and electrical installation work continues. On April 10, crews held a ‘topping out’ ceremony to celebrate the last steel beam getting put in place for the main building. Many workers signed their names on the beam before it was lifted by crane into position. Planning will soon start for commissioning activities. First up will be the water treatment plant this summer. The 3-kilometre (km) power line connecting Aspen to the grid is on track to be ready for service in May.

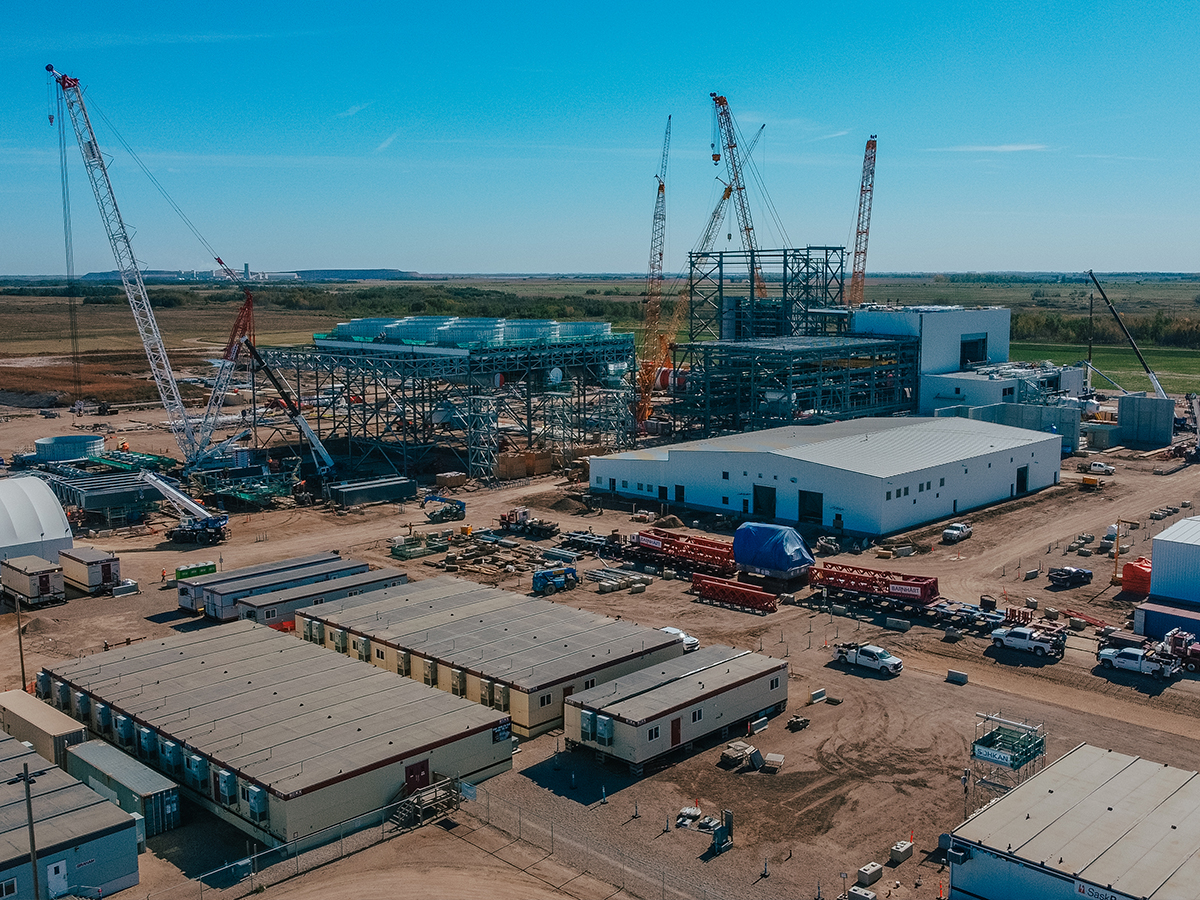

- Winter 2025-26 – As of February, the Aspen project is now 63% complete overall. Engineering is 95% complete, 93% of the project procurements have been awarded, and 95% of material and equipment has arrived on site. Construction itself is 44% complete with over 550 workers continuing to be on site daily. Major mechanical and electrical installation work is well underway throughout the entire site. Mechanical installation of the air-cooled condenser (ACC), gas turbine generator (GTG), heat recovery steam generator (HRSG), steam turbine generator (STG) and water treatment plants are well under way. Steel building construction is nearly complete.

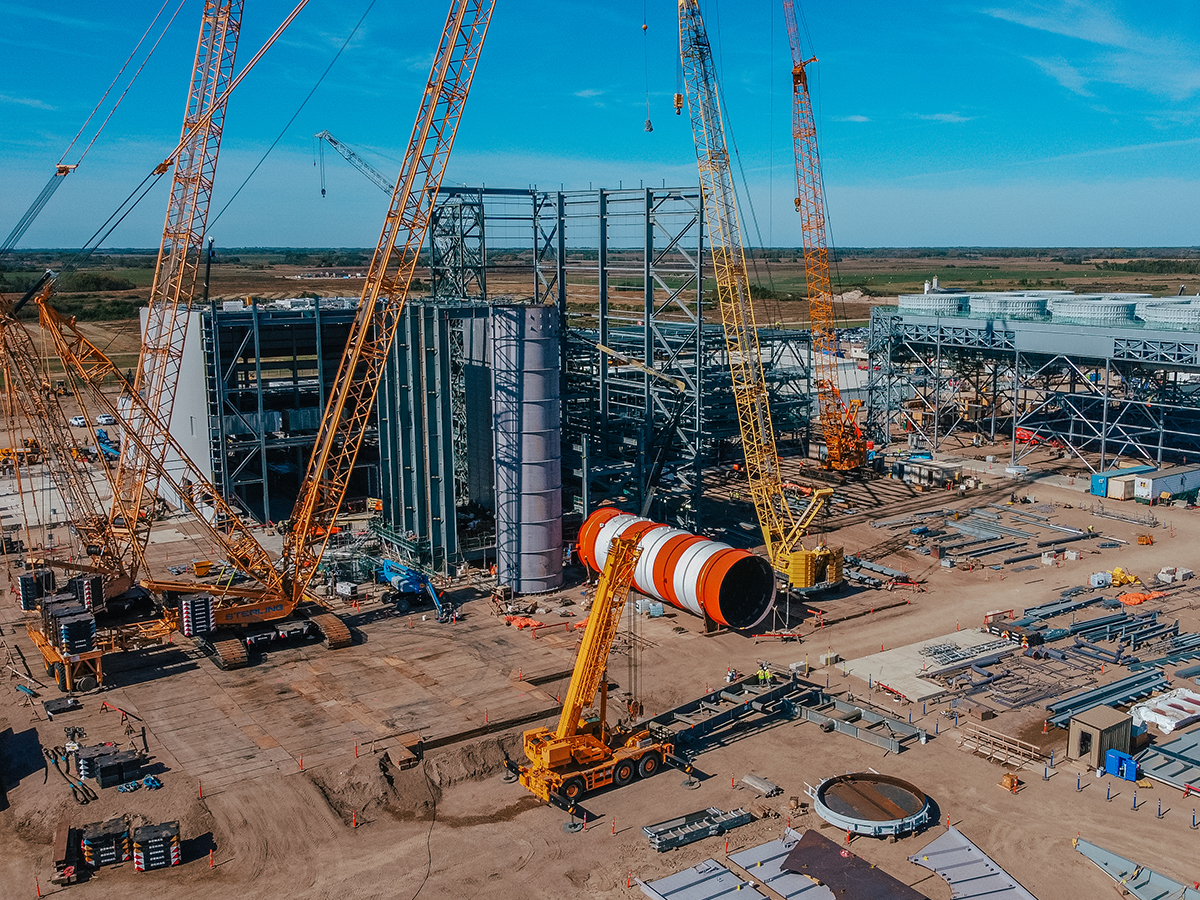

- Fall 2025 – Construction is now 30% complete as of September 30. More than 80% of all equipment and materials have been delivered to site, including the steam turbine, STG, and the HRSG. The gas turbine and GTG are set in place within the building. Sixteen large cranes are on site moving materials and helping with the vertical construction of buildings. Approximately 550 workers are on site each day.

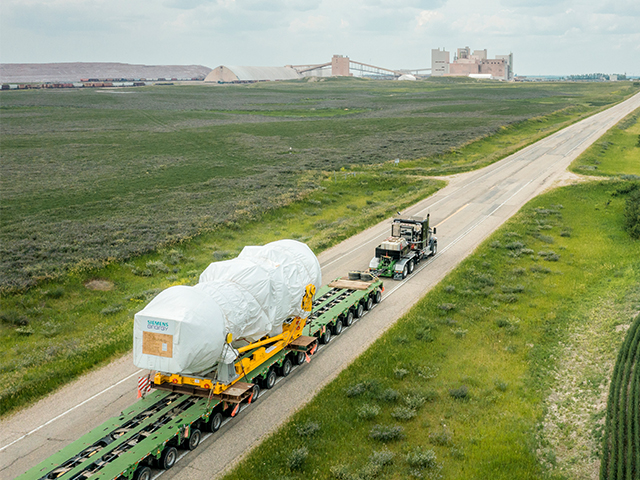

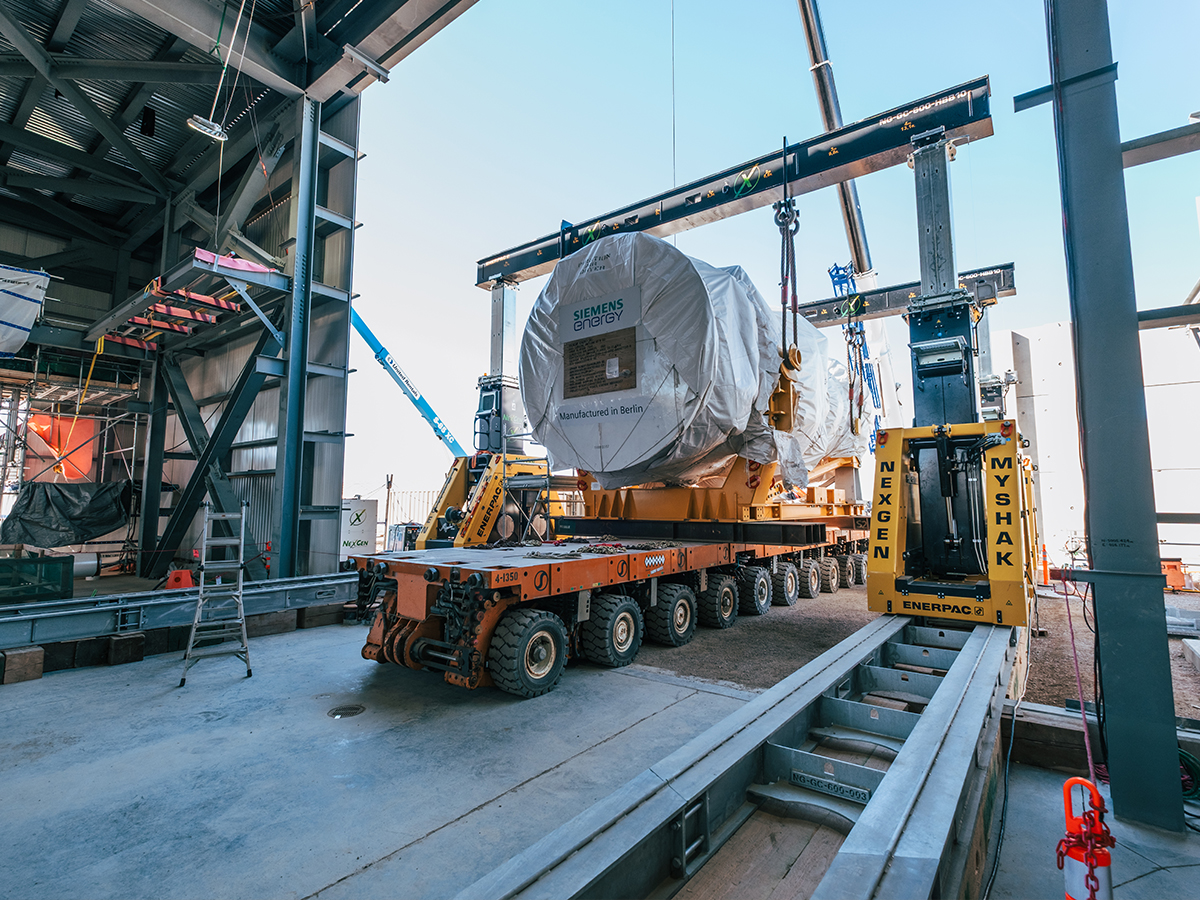

- Summer 2025 – The GTG was delivered to site on June 25, followed by the turbine itself on July 5. As of July 1, construction is around 20% complete. Overall, the project is 42% complete–this includes the procurement and engineering portions of the project. Over the summer months, more major equipment will continue to arrive. The STG is expected to arrive in September. A large 440-tonne crane is now on site, moving heavy steal into place. Structure foundations are on track to be complete in August. We’re averaging around 400 workers on site each day.

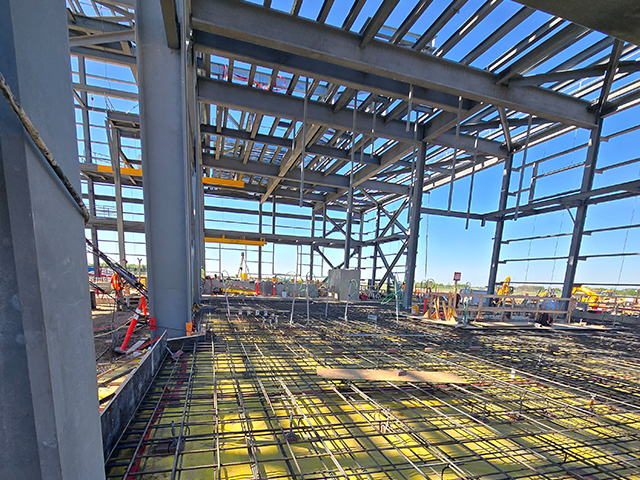

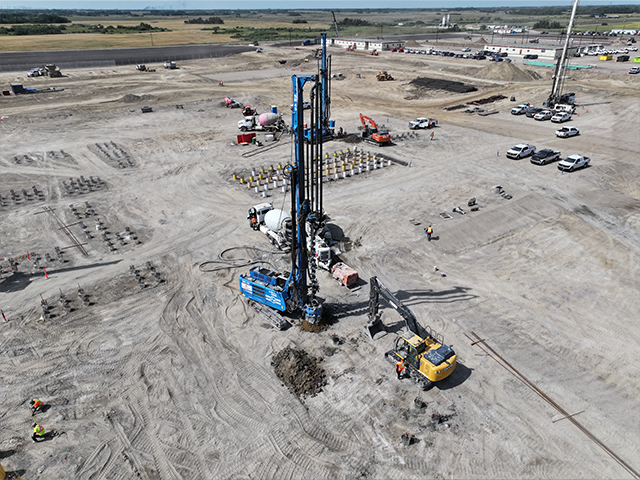

- Spring 2025 – As of April 30, the project is about 31% complete. More than 450 workers are on site each day. Foundations are almost all complete and vertical construction is underway. The first piece of structural steel for the air-cooled condenser was erected in March. The foundations were successfully pour for the GTG and STG amounting to a combined total of 948 cubic metres of concrete. Approximately 1,800 tons of structural steel has already been received on site for the GTG and STG building.
- Winter 2024-25 – Cement foundation work has begun. Structural steel and additional equipment continue to arrive on site. Willow Cree Development Corporation has been contracted to erect the air-cooled condenser. On average, there are more than 300 workers on site each day.

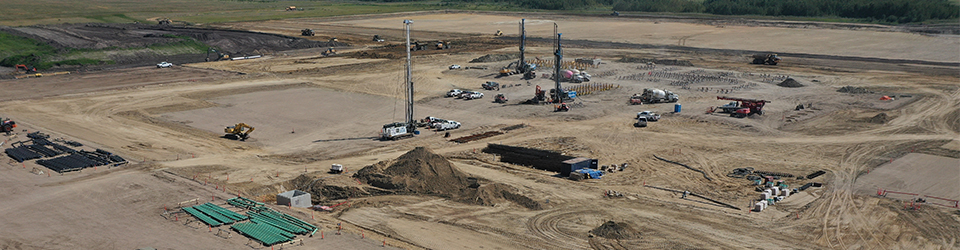

- Fall 2024 – As of Oct. 31, the project is 27% complete. All 1,350 piles are installed. The site’s evaporation pond is also almost complete. Work has begun on building foundations and underground utilities, which will continue through the winter months.
- Summer 2024 – Piling activities more than half complete. 2NationsBird is preparing to start underground piping, electrical and foundations work. On average, just under 100 workers are on site daily. This number is expected to rise to about 250 workers by fall.
- Spring 2024 – We selected Burns & McDonnell to be the engineer, procure, construct (EPC) partner to design and build the power station. We held a media event on Apr. 12 to announce the partnership and celebrate the start of construction. Allan Construction started site clearing and preparation activities. In June, Soletanche Bachy Canada started piling activities for approximately 1,500 piles.
- Winter 2023-24 – The Government of Saskatchewan confirmed that the project aligns with all requirements of the Saskatchewan Environmental Assessment Act.
- Fall 2023 – We signed an Engineering Services Agreement with Burns & McDonnell to begin preliminary design and project planning for the new power station. This allowed us to gain preliminary advice and involvement from the potential build contractor and allowed us to fast-track the design and purchase of major equipment.
- Summer 2023 – The Impact Assessment Agency of Canada (IAAC) determined that our Detailed Project Description submitted on Aug. 31, 2023 aligned with all federal regulations and a further impact assessment is not required.
- Winter 2022-23 – We decided on the name Aspen Power Station.
- Summer 2022 – The Lanigan area location was confirmed as the site for the new power station.
- Spring 2022 – We started technical studies and consultations with stakeholders, rightsholders and Indigenous groups.
- Spring 2020 – We started looking at potential sites for a new natural gas power station, including the Lanigan area.
